Several roofs in one project

When to add another roof to a project, how to switch between roofs, what they have in common and how to archive or delete a roof.

When to add another roof

  • One roof is enough for a typical project.
  • Add another roof when the building has a separate part that you want to enter and evaluate separately, for example an extension or another wing.
  • Each roof has its own outline, calculations and results. A figure for one roof never applies to another.
  • All roofs of a project have the same type. For a flat roof they also have the same structural deck type, see New project and roof type.

Add a roof

  1. In the project cockpit, open the Roofs tab.
  2. Click Add roof, type a name and click Create and open.
  3. The new roof is empty and becomes active. You draw it in the editor, see Drawing a roof.

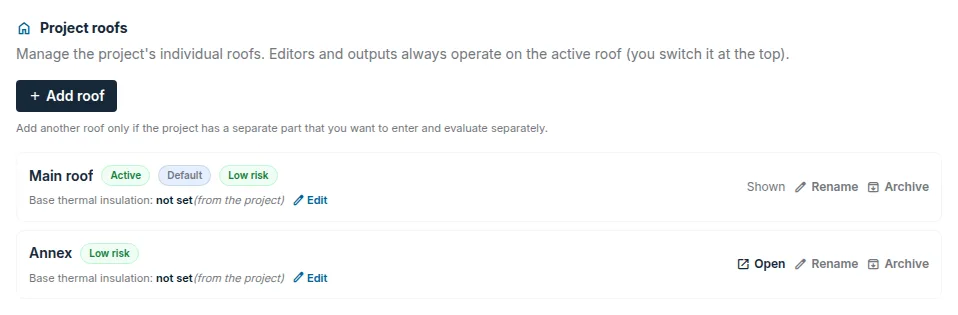

The Roofs tab in the project cockpit: two roofs, the active roof and the Add roof button

In the flat roof editor:

  • Add section at the end of the roof switcher menu adds a roof in the same way.
  • When you draw another outline in a roof that already has an area, the editor asks whether to create a new roof from it. If you confirm, a new roof is created and the editor switches to it. The new roof gets its own copy of the background and the scale of the previous roof. The original roof stays unchanged. If you cancel, the drawn outline is discarded.

Switch the active roof

  • The project cockpit, the editors and the results always work with one roof, the active roof.
  • In the project cockpit, the Active roof switcher is in the header of the Roofs, Calculations and Reports tabs, to the right of the heading, below it on a phone. In the editor, it is the first row at the top of the left panel, without a heading. Click it and choose a roof. In a project with many roofs, you can search by name.
  • After switching, you stay on the same tab.
  • A project with a single roof has no switcher.
  • The flat roof editor saves the drawing in progress before switching. If saving fails, it stays on the original roof. The other editors ask in the Switch without saving? window when there is unsaved work; Cancel is the default.
  • After switching, no area or edge of the previous roof stays selected and the left panel starts at the top. The page address points to the new roof, so reloading the page opens it again.

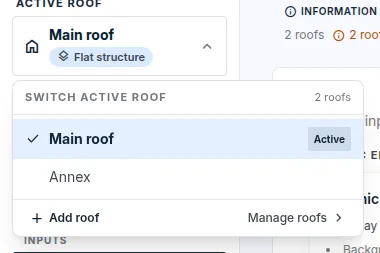

The open Active roof switcher in the header of the Roofs tab with two roofs

Roof status: what is done and what is missing

  • Next to the roof name in the switcher there is a small status mark: a tick when everything on this page is entered, or an exclamation mark when something is missing. Click the mark to open the Roof status window (Façade status for a façade).
  • The window shows the whole roof in the groups Roof input, Calculations and Outputs. At the top, the block This page shows what you are editing right now, including unsaved changes. Each item has a state (Done, Missing, Not entered yet, Out of date), what is missing, and a line Affects: …, that is, what cannot be calculated without it.
  • The button on an item takes you to the matching settings or page, the same way as the continue buttons in the Steps window. The window itself never calculates, saves or exports anything.
  • In calculations (anchoring, slopes, hall, façade layout) the mark shows the state of that calculation: an exclamation mark when input is missing, the result is out of date, or something not yet entered is holding it back. The button opens the settings window at the first missing step.
  • For fall protection, Done appears only when the design check finds nothing that blocks release. Otherwise the window gives one sentence from the check and the button Show finding, or Open Evaluation for a finding without a place on the canvas. A ready design with unverified anchor heights shows Note (orientational output); the badge in the roof switcher and the window say the same.
  • A roof you are not editing has a mark without a state in the switcher. Its state is shown by the window once you switch to it.

What roofs have in common

  • In the Roof materials window in the editor and on the Drainage page, a setting has a badge showing what it applies to: Whole project for the whole project, Active roof only for this roof, Project + roof for a project default that can be overridden for the roof.
  • A change of the project default does not carry over to a roof that has its own value.
  • You set the base thermal insulation on the Roofs tab for each roof. An empty field means the value from the project.
  • The expandable Results per roof table at the top of the Reports tab shows the results of all roofs side by side, with a Project total row.
  • You build the report, the documents for suppliers and the material take-off for the active roof, or with the Whole project option at the top of the Reports tab. More in the guide Reports.
  • Each roof has its own background and scale. You can take them over into an empty roof from another roof of the project, see Background and scale.

Rename, archive, delete

On the Roofs tab, for each roof:

  • Rename changes the name.
  • Archive hides the roof from routine work without deleting the data. Archived roofs are not included in the overall totals. You bring a roof back with the Restore button.
  • Only an archived roof that is not the last one in the project can be deleted permanently. Delete an empty roof with the Delete permanently button and a roof with data with the Delete permanently, including data button. Deletion cannot be undone.
  • A project must have at least one active roof.
  • Archiving a roof is not archiving the project. You archive the whole project in the projects overview, see Projects overview.

Facades

In a Facade project, you add facades instead of roofs: the Facades tab, the Add facade button. Switching, archiving and deleting work the same way. More in the guide Facade panel layout.
